The master production schedule is where the plan meets reality. Get it wrong and everything downstream — purchasing, production, shipping — falls apart. A missed quantity in week three doesn’t stay in week three; it propagates through material orders, labor assignments, and customer commitments before anyone catches it.
The MPS is the document that production planners, operations managers, and supply chain teams live inside. It sits at the intersection of demand signals and production capacity, translating what the business needs to sell into what the plant needs to build. This guide covers how the MPS is structured, how it connects to MRP and aggregate planning, how forecasting feeds it, and what software needs to do to manage it without breaking under real operating conditions. If you already know the basics and want to check whether this goes deep enough — it does.
What Is a Master Production Schedule?
A master production schedule is a time-phased plan that specifies how many finished goods to produce, and when. It does not answer how — that’s the shop floor schedule’s job. The MPS answers two questions only: what to produce, and when to have it ready.
To define master production schedule precisely: it is an item-level, time-bucketed production plan that drives both material requirements planning and capacity loading. A master production schedule specifies finished goods quantities, due dates, and timing — not the raw materials, routings, or labor allocations needed to execute it.

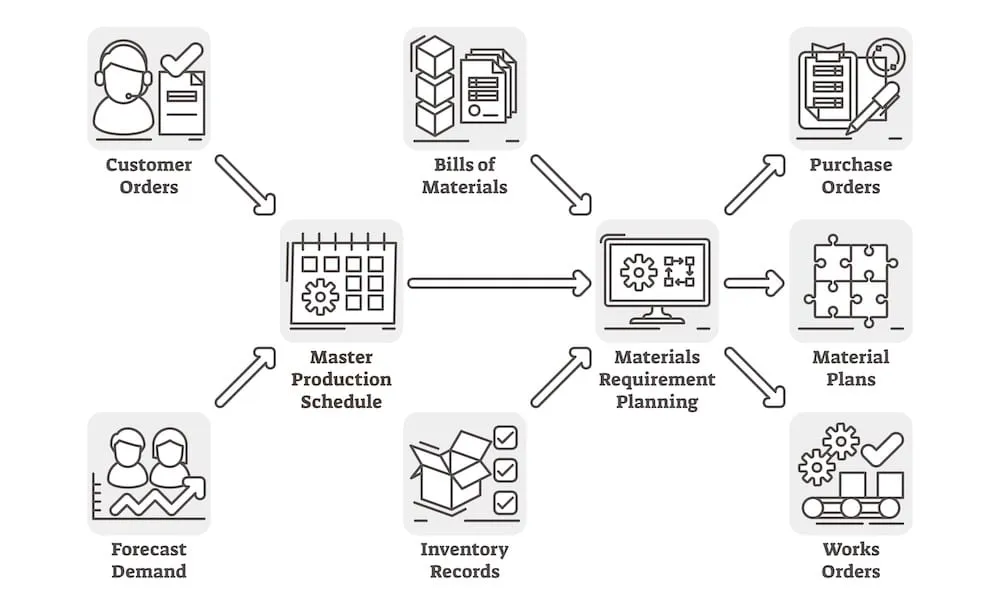

The MPS pulls from four primary inputs:
Statistical demand forecast
Confirmed customer orders
On-hand inventory and scheduled receipts
Available production capacity
The distinction between an MPS and a production schedule matters. The MPS is the planned target — it represents what the business has committed to producing by period. The shop floor schedule is the execution layer: who runs which job, on which machine, in what sequence. Conflating the two is how planners end up managing execution problems at the planning level, and capacity problems at the execution level.
Timeframe varies by industry. Discrete manufacturers with long supplier lead times often run a rolling 12–16 week horizon. Food and beverage operations with short shelf lives and high-volume SKUs may run 4–8 weeks. The horizon should extend at least as far as your longest material lead time, or the MPS loses its ability to drive purchasing decisions.
MPS and the Planning Hierarchy
The MPS does not operate in isolation. It sits in the middle of a four-layer planning hierarchy:
S&OP → Master Production Schedule → MRP → Shop Floor Scheduling
Sales and operations planning (S&OP) works at the aggregate level — product families, 3–18 month horizon. It sets the capacity envelope: how many shifts, how many lines, how much labor. It does not distinguish between individual SKUs. Its output is a production plan by family, expressed in units or hours.
The MPS takes that aggregate plan and disaggregates it. If S&OP says the plant needs to produce 10,000 units of the beverage concentrate family in week six, the MPS specifies that 4,200 of those are SKU A, 3,800 are SKU B, and 2,000 are SKU C — each with its own production slot and due date.
MRP then uses the approved MPS as its primary input. Given that the MPS calls for X finished goods by date Y, MRP back-calculates what components, sub-assemblies, and raw materials need to be ordered or produced, and when. The MPS is the trigger; MRP is the explosion.
Shop floor scheduling takes MRP’s planned orders and turns them into work orders with assigned resources, sequences, and run times.
This chain has a critical implication: changes to the MPS ripple in both directions. A new order added to week three doesn’t just affect that week’s production count — it drives a material requirements recalculation, potentially triggers new purchase orders, and competes for capacity with everything else already scheduled. This is the core argument for MPS stability. Aggregate planning and master production scheduling are sequential, not parallel — the aggregate plan sets the ceiling, and the MPS allocates within it. Organizations that skip aggregate planning and take sales forecasts directly to the MPS end up with a schedule that constantly fights itself.
Model
What It Means
Who Manages Logistics
1PL (First-Party Logistics)
A company ships its own goods with its own assets
The company itself
2PL (Second-Party Logistics)
A company contracts carriers or trucking firms directly
The company, using contracted transport
3PL (Third-Party Logistics)
An independent operator handles warehousing and/or fulfillment on behalf of clients
The 3PL operator
4PL (Fourth-Party Logistics)
A management layer that oversees and coordinates multiple 3PLs and logistics providers
The 4PL, acting as supply chain integrator
The planning logic here is straightforward. Planned production equals the greater of forecast demand or confirmed orders, adjusted to maintain the safety stock buffer. In Week 1, confirmed orders (200) exceed the forecast (180), so planned production is set at 200. In Week 2, the forecast (160) exceeds confirmed orders (120), so the forecast drives planned production — 150 units covers the 160 forecast demand while accounting for the 50-unit buffer already on hand.
Now add a mid-cycle disruption: a large customer order arrives late for Week 2, adding 60 units to confirmed orders. That single change doesn’t stay in Week 2. If production capacity is already committed, the overage pushes into Week 3, which increases Week 3’s planned production requirement and competes with the 190-unit forecast already planned there. Week 4 absorbs the spillover. One late order has now touched three planning periods — and if those periods are inside the frozen zone, the disruption cost multiplies.
Production offset is the mechanism that handles lead time in the MPS. When a finished good requires two weeks of production time, the MPS must schedule production to start two weeks before the due date. A product needed in Week 4 must appear in the MPS in Week 2. ERP and MRP systems back-calculate from the due date using the item’s lead time to determine the production start date. This offset is configured at the item level — get it wrong and you’re scheduling production that can’t physically be completed on time.
The MPS Process: How It Actually Works
Master Production Day and Agent Production Day
These terms appear in MRP and ERP planning engines and are worth understanding precisely. A master production day is a scheduled working day used as the base unit for capacity planning. Rather than planning against calendar days — which vary between 28 and 31 per month and include weekends and holidays — the system plans against a normalized count of actual working days. This keeps capacity calculations consistent across months with different calendars.
An agent production day is the capacity unit assigned to a specific production agent — a machine, a production line, or a crew — within the master schedule. It answers a specific question: how much can this resource produce in one working day? The MPS allocates production quantities against these units to prevent over-scheduling any individual resource.
Together, these concepts prevent the most common MPS error: paper capacity. Just because a month contains 22 working days doesn’t mean every resource can run at full output all 22 of those days. Planned maintenance, shift transitions, equipment qualification windows, and operator availability all reduce effective capacity. Planning against master production days and agent production days forces the schedule to reflect real throughput, not theoretical maximums.
The MPS Planning Cycle
Gather demand inputs — confirmed orders plus statistical forecast for the planning horizon
Check available inventory and scheduled receipts, including open purchase orders and already-planned production runs
Calculate net requirements: what the MPS must cover after subtracting on-hand inventory and incoming supply
Time-phase quantities against available capacity, applying master production day and agent production day constraints
Freeze the near-term horizon — the frozen zone — where changes require formal approval
Review and approve with production, purchasing, and sales in the MPS meeting
Release the approved MPS to MRP for material requirements calculation
The MPS Meeting
The MPS review meeting typically runs weekly or biweekly. Attendees include the production planner, operations manager, purchasing lead, and a sales or customer service representative. The agenda is not a status update — it is a decision-making session. The group reviews open exceptions (late orders, capacity conflicts, supplier delays), evaluates any change requests to the frozen zone, and confirms that demand signal updates outside the frozen zone are reflected in the upcoming MPS revision.
The output is an approved MPS that all functions have committed to. That commitment is the point. An MPS that purchasing doesn’t know about, or that sales believes can be modified at will, is not a plan — it’s a spreadsheet with a formal name.
Demand Inputs and Forecasting Techniques
Two statistical methods dominate MPS demand planning in practice.
Simple moving average takes the mean demand across the last N periods. It performs well for stable, low-variability demand patterns. Its weakness is responsiveness — it weights all historical periods equally, so a genuine demand shift takes several cycles to register in the forecast. For products with seasonal spikes or trend changes, it lags.
Exponential smoothing addresses that lag by weighting recent periods more heavily than older ones. The smoothing factor alpha — typically set between 0.1 and 0.3 — controls the sensitivity. A higher alpha makes the forecast more reactive to recent demand; a lower alpha produces a smoother, more stable output. Most MRP and ERP systems apply exponential smoothing automatically with a configurable alpha. Planners set the sensitivity level; the system recalculates with each new period of actual demand. For most discrete and process manufacturers, exponential smoothing is the default method because it balances responsiveness with stability without requiring manual adjustment each cycle.
Regardless of the statistical method, confirmed customer orders override the forecast in the near-term horizon — typically the nearest 4–8 weeks. Where actual demand is known, the MPS uses it. Where it isn’t, the statistical forecast fills the gap. The transition point between order-driven and forecast-driven planning is called the demand time fence, and it should be configured to align with your customers’ ordering patterns and your own production lead times.
Aggregate Planning vs. Master Production Scheduling
Aggregate planning and master production scheduling address different questions at different levels of resolution. Aggregate planning operates at the product family level over a 3–18 month horizon. It determines resource requirements in broad terms: how many total production hours, how many shifts, whether to build inventory or use overtime to absorb peak demand. It does not distinguish between individual SKUs.
The MPS operates at the item level over a rolling horizon of weeks to months. It takes the capacity ceiling established by aggregate planning and fills it with specific finished goods quantities by week. Where aggregate planning asks “how much overall capacity do we need in Q3?”, the MPS asks “how many units of SKU X do we build in week 11?”
They work in sequence. The aggregate plan sets the production envelope; the MPS allocates within it. Running MPS without an upstream aggregate plan is one of the most common structural failures in manufacturing planning. Without the aggregate ceiling, the MPS has no constraint — planners accept demand signals from sales without a check on whether total capacity exists to support them. The result is a schedule that overpromises, a shop floor that expedites constantly, and a purchasing team reacting to daily changes rather than working to a stable plan.
MPS Challenges and How Software Solves Them
The MPS is a live document in a dynamic environment. The challenges planners face are not theoretical.
Demand volatility means the MPS is always chasing a moving target. Forecasts miss, customers change orders, and new opportunities arrive outside the normal planning cycle. A static spreadsheet-based MPS cannot recalculate net requirements automatically when a demand signal changes — someone has to update it manually, which introduces lag and errors.
Capacity constraints are rarely uniform across the planning horizon. Maintenance windows, holidays, equipment qualification periods for regulated industries, and shift changes all reduce available production days in specific weeks. An MPS that ignores this schedules more than the plant can actually produce.
Multi-level BOMs mean that a change to a finished goods quantity in the MPS cascades through sub-assemblies and raw materials. If the MPS and MRP are not tightly integrated, purchasing may be working from a material plan that no longer matches the current production plan.
Benefits of Freezing the Master Production Schedule
The frozen zone — typically the nearest 4–8 weeks — is the period where the MPS should not change without a formal change request and multi-function sign-off. The benefits of freezing the master production schedule are practical and measurable.
Freezing gives purchasing a stable target. Supplier lead times cannot accommodate daily MPS revisions — when the plan changes constantly inside the procurement window, purchasing either over-orders to hedge or under-orders and creates shortages. A frozen zone eliminates that uncertainty for the near-term horizon.
It gives the shop floor a reliable execution window. Operators and supervisors can sequence work, set up equipment, and allocate labor around a schedule they know will not change overnight. Unplanned changeovers and sequence disruptions are among the highest-cost inefficiencies in discrete and process manufacturing — most of them trace back to an unstable MPS.
Freezing also makes the cost of last-minute changes visible. When a change request requires sign-off from production, purchasing, and sales, the business has to weigh whether the accommodation is worth the disruption. That friction is intentional — it filters out low-value changes and forces the organization to absorb demand variability in the right place, which is inventory policy, not the production schedule.
What MPS software needs to support this effectively: automatic net requirements recalculation when demand changes outside the frozen zone; frozen zone enforcement that flags proposed changes rather than silently accepting them; direct MRP integration so approved MPS changes propagate to material orders without a manual handoff; and a shared, real-time planning view that gives planners and management the same data.
ASC Software’s MRP integrates directly with its MES and warehouse management modules. When the MPS changes, material requirements and shop floor work orders update within the same system — no spreadsheet exports, no reconciliation between disconnected tools.
Conclusion
The MPS is only as good as the system maintaining it. Spreadsheet-based planning breaks down the moment demand shifts or a machine goes down — planners end up spending their time on reconciliation instead of decision-making. A purpose-built MRP system with native MPS management enforces planning discipline, maintains frozen zone integrity, and keeps material and production plans synchronized without manual intervention.
If your current planning process involves exporting data between systems to get the MPS and MRP aligned, that’s the problem worth solving first.
See how ASC’s MRP manages master production scheduling
Frequently Asked Questions
What does a master production schedule specify?
The MPS specifies finished goods quantities, production timing, and due dates — not the materials or labor required to make them. It answers “what to produce and when,” not “how.” The MRP system takes the MPS and explodes it into material requirements.
What is the difference between MPS and MRP?
The MPS is the plan for finished goods — quantities and timing. MRP (Material Requirements Planning) uses the MPS as input and calculates what raw materials, sub-components, and purchased items need to be ordered or produced to meet it. MPS drives MRP, not the other way around.
How often should a master production schedule be updated?
Most manufacturers run a weekly MPS review cycle, with a frozen zone covering the nearest 4–8 weeks. Outside the frozen zone, the MPS should update as demand signals change. Inside the frozen zone, changes require formal approval to prevent disrupting supplier commitments and shop floor scheduling.
